How to Buy a Used Concrete Pump Truck for Pakistan: Price, Inspection, Documents, and Shipping
From Operators to Global Exporters
Buying a used concrete pump truck from China for a project in Pakistan should be managed as a sequence of decisions, not as a single price negotiation. First define the machine your project needs. Then request a quotation with a clear trade term, collect evidence for the exact unit, inspect it, verify the seller and payment path, confirm Pakistan’s current import requirements, and only then finalize shipping.
The safest comparison is not “Which truck has the lowest advertised price?” It is “Which verified machine can reach my project with the required documents, acceptable condition, and a clearly allocated total cost?”

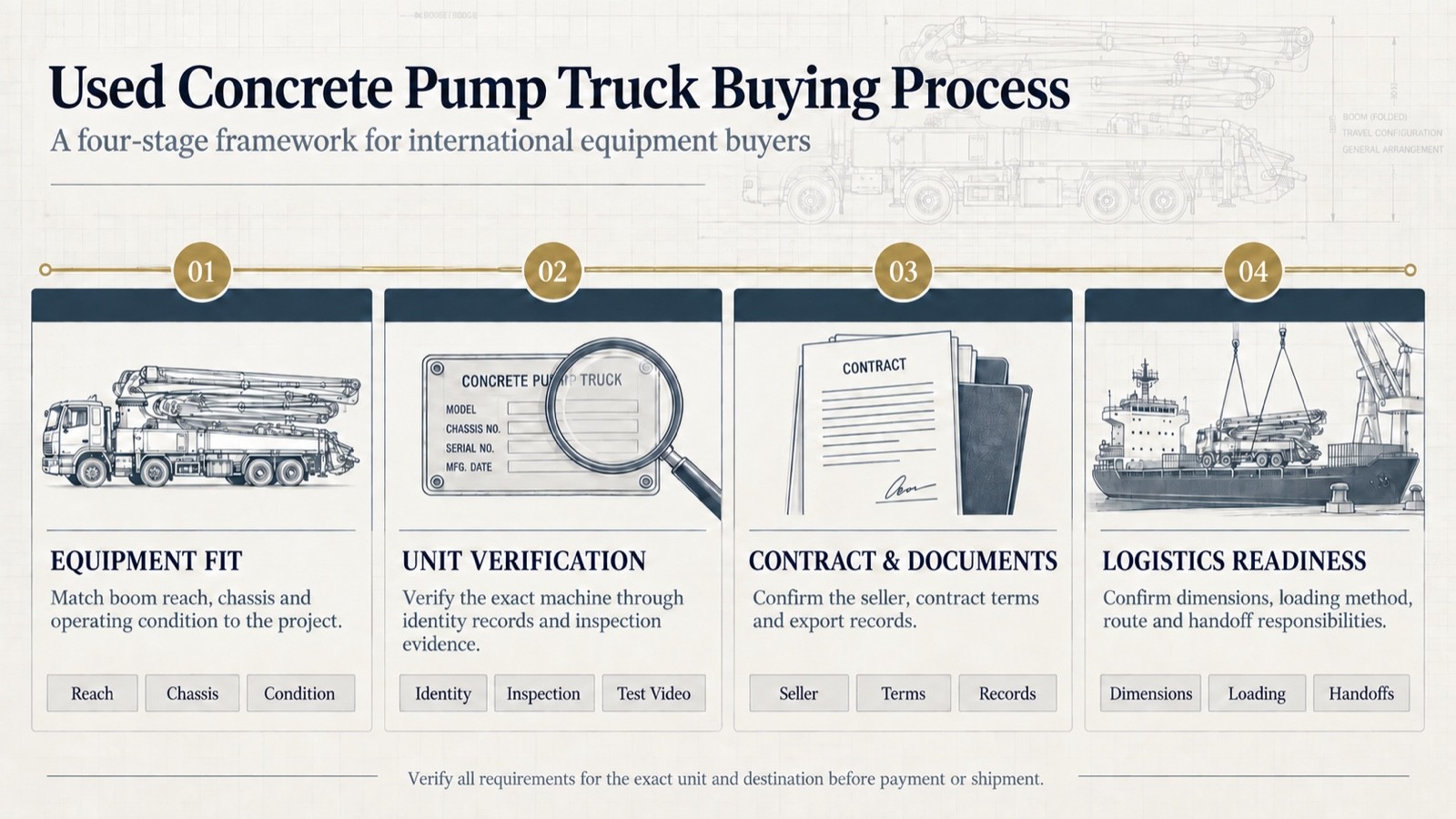

1. Define the job before requesting a quotation
A seller cannot prepare a useful shortlist from the words “concrete pump needed” alone. Send a short project brief covering:
- required boom range or placing method;
- typical pour type, site access, road and setup-space constraints;
- preferred brand, chassis, model year range, or emissions requirement, if any;
- destination city and intended port or inland delivery point;
- target purchase timing;
- whether your technical team will inspect in person, appoint a third party, or begin with live video;
- the quotation basis you want to compare, such as EXW, an agreed port term, or a separately itemized shipping estimate.
If boom length is not yet decided, use the concrete pump truck boom length guide before choosing a unit. A longer boom is not automatically the better purchase: road access, outrigger space, chassis size, maintenance capacity, and the actual placing plan matter.
2. Ask for a quotation that can be compared
Two quotations are not comparable unless they use the same scope. The document should identify the exact machine and state at least:
- brand, model code, model year, chassis, and identifying number used by the seller;
- quoted currency and validity period;
- named delivery place or port;
- Incoterms rule and version, when an Incoterms rule is used;
- whether inland movement, export handling, port charges, ocean freight, insurance, destination charges, customs clearance, duties, taxes, and inland delivery are included or excluded;
- inspection, repair, spare-part, cleaning, loading, or dismantling work included in the offer;
- payment stages and the evidence required before each stage.
Under Incoterms 2020, EXW generally means the seller makes the goods available at the named place, while the buyer takes on most transport and clearance responsibilities from that point. FOB, CFR, and CIF are rules for sea or inland-waterway transport and allocate cost and risk differently. The named place, port, loading method, and exact rule matter. Use the ICC Incoterms 2020 guidance and have your freight forwarder confirm which term fits the actual movement.
Do not treat an EXW number as the landed cost in Pakistan. For a fuller cost framework, also review the used concrete pump truck price guide.

3. Build an evidence pack for the exact unit
Before discussing a deposit, ask for evidence tied to the same machine shown in the quotation. A useful pack includes:
- full exterior photos from all sides;
- chassis, cab, tyres, outriggers, boom sections, hydraulic areas, hopper, pumping unit, and control-system photos;
- clear nameplate and identification images;
- cold-start and dashboard video;
- live or continuous video showing outrigger deployment and controlled boom movement by a qualified operator;
- video or records showing the pumping system’s present condition, where safe and practically available;
- available maintenance, repair, inspection, or test records, with missing records clearly identified;
- a current written condition summary listing known defects and proposed work;
- dimensional and weight information required for transport planning, verified against the exact unit;
- the seller’s ownership or authority-to-sell evidence and contracting entity details.
Photos, video, records, and seller statements answer different questions. A polished video does not prove ownership, maintenance history, structural integrity, or the absence of hidden defects. Use the used concrete pump truck inspection checklist to organize the technical review.
4. Choose the right inspection level
Remote video inspection
Remote video is useful for screening. Ask for a planned live call, identify the unit at the beginning, and request continuous sequences rather than only edited clips. Record open questions and ask the seller to show them again from another angle.
Independent inspection
If your team cannot travel, a qualified independent inspector can verify the machine against an agreed checklist. Define the inspection scope in writing: identity, visible structure, chassis, boom, hydraulics, pumping system, controls, functional checks, documents, photos, and exceptions.
Buyer-team yard inspection
An on-site visit provides the strongest opportunity to compare the quoted unit with its documents and to witness safe functional checks. Agree in advance on the date, available tests, responsible operator, site safety rules, access to records, and how findings will affect the offer.
No inspection method eliminates all risk. The objective is to make the remaining risk visible enough to price, repair, accept, or reject.
5. Verify the seller and payment path
Confirm who owns or is authorized to sell the equipment, who signs the contract, and which legal entity receives payment. Match names across the quotation, proforma invoice, contract, bank details, and company records. Independently verify any last-minute bank-account change using a known contact method.
Also confirm how discrepancies will be handled. The contract should identify the exact unit, agreed condition, included work, inspection rights, delivery point, document responsibilities, payment milestones, and remedies for material mismatch. See the supplier verification guide for a broader due-diligence checklist.
6. Confirm Pakistan import requirements before shipment
Do not rely on a generic online duty figure or an HS code copied from another machine. Classification and regulatory requirements depend on the exact equipment, configuration, condition, and current rules.
Pakistan Single Window provides the electronic interface for import declarations and routes information to the relevant government agencies. Its import workflow asks the filer to add commodity information and upload the documents required for that declaration. Review the current Pakistan Single Window import guidance, then ask a licensed Pakistan customs agent or broker to confirm:
- the correct HS classification and product description;
- whether the exact used machine is eligible for import at the planned date;
- applicable licenses, permits, certificates, inspections, or other approvals;
- valuation method, duties, taxes, fees, and payment procedure;
- required document originals, electronic records, translations, or attestations;
- port, terminal, age, condition, emissions, registration, or road-use requirements;
- who will file the declaration and who will receive customs or agency notices.
The required-document list must come from the current declaration and the authorities or broker handling the exact shipment. A typical commercial and transport file may include a contract, commercial invoice, packing or specification list, bill of lading, and origin or inspection documents when applicable, but this is not a definitive Pakistan import checklist.
7. Plan shipping as a chain of handoffs
A pump truck’s shipping plan depends on its verified dimensions, weight, boom configuration, chassis, loading method, route, and carrier acceptance. Ask the forwarder to state:
- pickup point and responsibility for inland transport in China;
- export-handling responsibility;
- loading method and whether any parts will be secured or removed;
- origin and destination ports;
- ocean transport method;
- insurance scope and declared value;
- destination handling and storage exposure;
- customs-agent responsibility;
- inland delivery arrangements in Pakistan;
- photo and document evidence at pickup, loading, and handover.
Do not publish a fixed freight price or delivery time without a dated quotation for the exact unit and route. The shipping guide for used concrete pump trucks explains the planning inputs in more detail.
8. Final pre-payment checklist
Before releasing the agreed payment stage, confirm that:
- the contract, invoice, evidence pack, inspection result, and bank beneficiary refer to the same unit and seller;
- every model code, year, chassis, dimension, weight, price, and included item is consistent;
- defects and promised work are written down;
- the trade term includes a named place or port and a clear scope;
- the Pakistan broker has checked current classification and import requirements;
- the forwarder has checked the machine data and route;
- payment milestones are linked to defined evidence or handoff events;
- the final loading and document plan has an owner and deadline.
Frequently asked questions
What should a Pakistan buyer request before paying a deposit?
Request an exact-unit quotation, seller and bank verification, identification photos, a condition and evidence pack, an agreed inspection method, written trade terms, and preliminary confirmation from your Pakistan broker that the planned machine and document route are workable.
Is an EXW quotation the final cost in Pakistan?
No. EXW is a delivery term, not a landed-cost calculation. Transport, handling, freight, insurance, customs services, duties, taxes, storage, and inland delivery may sit outside the quoted amount. Confirm every cost item and responsibility separately.
Can our technical team inspect the machine in China?
An on-site inspection can be arranged only after the seller confirms the exact unit, yard schedule, available tests, responsible operator, visitor requirements, and safety rules. Put the agreed inspection scope in writing before travel.
Which import documents are required in Pakistan?
The list depends on current rules, the exact HS/product classification, and the selected declaration. Check Pakistan Single Window and obtain written advice from the customs agent handling the shipment. Do not rely on a generic checklist as legal clearance advice.
How should we compare two pump-truck quotations?
Normalize the machine identity, condition evidence, included repairs, trade term, named place, shipping scope, document responsibilities, payment milestones, and exclusions. Only then compare price.
Next step
Send SHIRUN your required boom range, preferred brand or chassis, project location, inspection plan, and quotation basis. We can prepare a current shortlist and identify the evidence needed for each unit. Review the current 2022 Zoomlion 38m product page as an example of the information to verify, but confirm availability and every specification again before contracting. You can also contact SHIRUN with your project brief.
